Project Portfolio Management (PPM)¶
The PPM module provides a complete project portfolio management solution for tracking initiatives, budgets, risks, tasks, and timelines. It integrates directly with the Initiative card type to enrich each project with status reporting, cost tracking, and Gantt visualization.
Note
The PPM module can be enabled or disabled by an administrator in Settings. When disabled, PPM navigation and features are hidden.

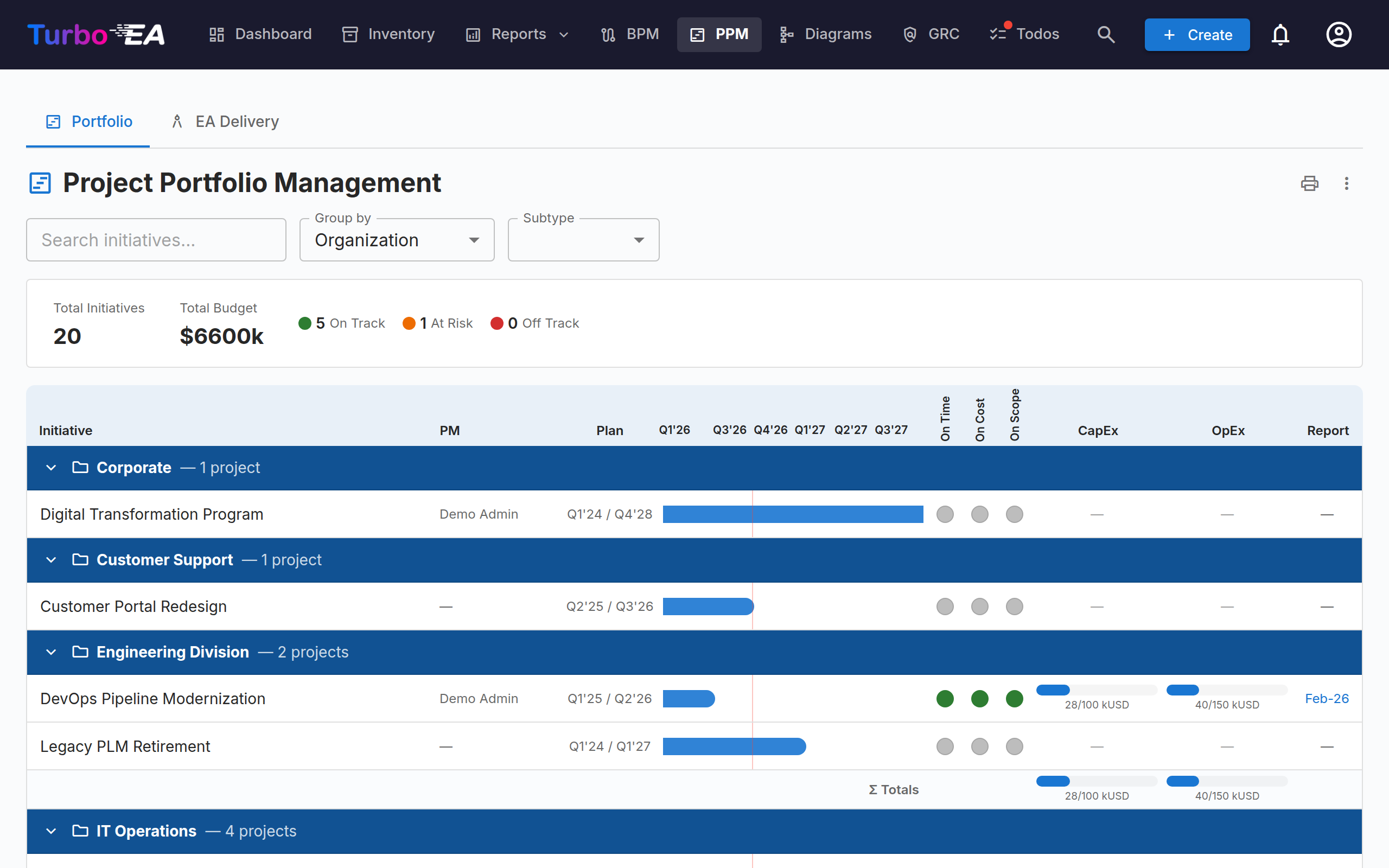

Portfolio Dashboard¶

The Portfolio Dashboard is the main entry point for PPM. It provides:
- KPI Cards — Total initiatives, total budget, total actual cost, and health status summaries
- Health Pie Charts — Distribution of schedule, cost, and scope health (On Track / At Risk / Off Track)
- Status Distribution — Breakdown by initiative subtype and status
- Gantt Overview — Timeline bars showing each initiative's start and end dates, with RAG health indicators
Grouping & Filtering¶
Use the toolbar to:
- Group by any related card type (e.g., Organization, Platform) to see initiatives grouped by business unit or technology platform
- Filter by subtype (Idea, Program, Project, Epic)
- Search by initiative name
These filters persist in the URL, so refreshing the page retains your current view.
Printing & exporting¶
The portfolio offers the same title-bar actions as the reports:
- Print / Save as PDF — the printer icon prints the portfolio the way it looks on screen. The tab strip, the filter toolbar and hover popovers are dropped, the active grouping / subtype / search are printed as a compact parameter line, and the timeline grid is unclipped so every column fits the page instead of being cut off at the scroll edge.
- Export to PowerPoint (.pptx) — from the ⋮ menu. The first slide carries the title, the generation timestamp and the active filters together with the portfolio at presentation quality; long portfolios continue onto further slides, split only between initiatives — never through a row, a group header or a totals line.
- Export to Excel (.xlsx) — also from the ⋮ menu. One row per initiative with its group, subtype, project manager, start and end dates, the three health ratings, CapEx / OpEx planned vs. actual, and the date of the latest status report.
Initiative Detail View¶
Click any initiative to open its detail page with seven tabs:

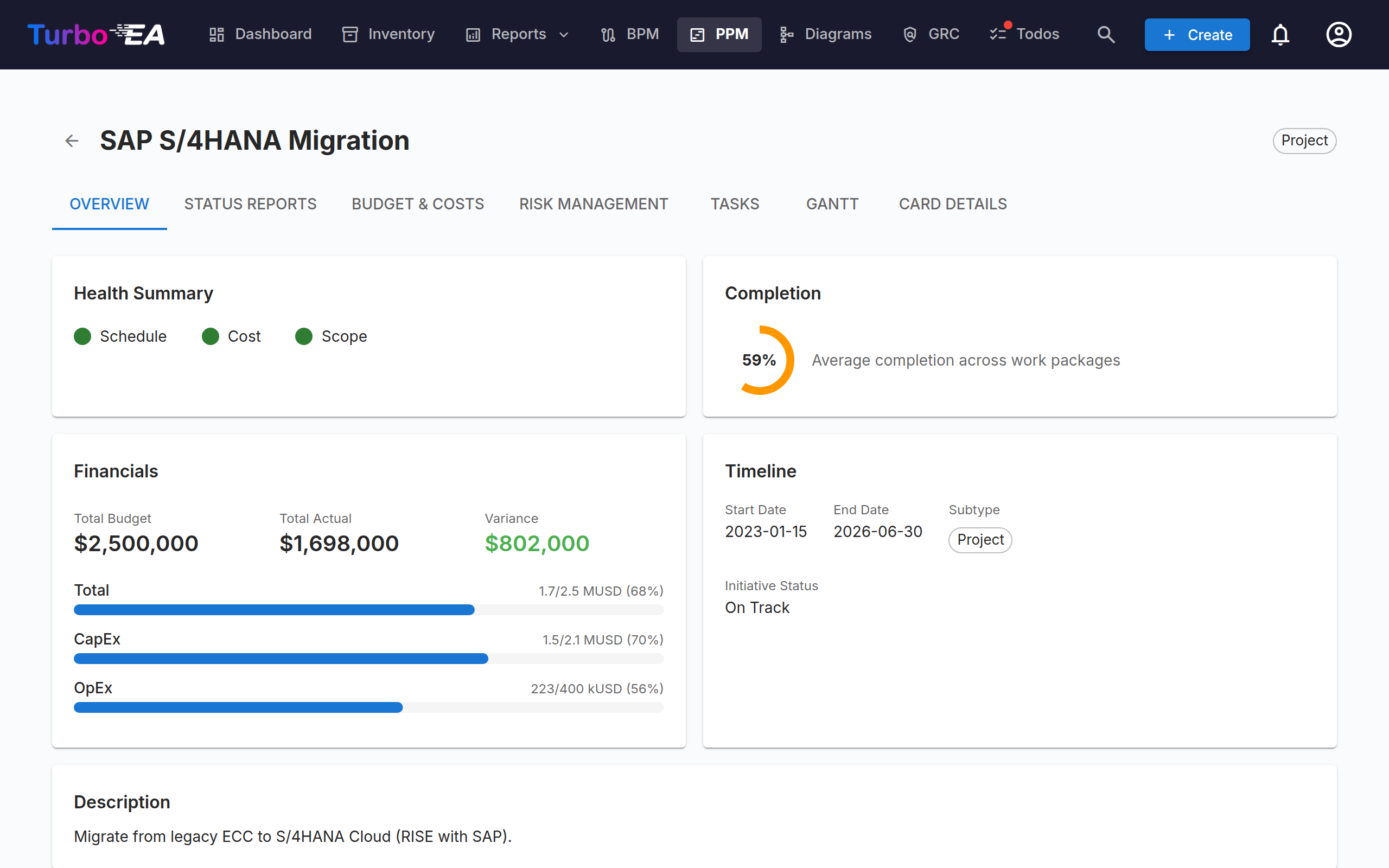

Overview Tab¶

The overview shows a summary of the initiative's health and financials:
- Health Summary — Schedule, cost, and scope indicators from the latest status report
- Budget vs. Actual — Combined KPI card showing total budget and actual spend with variance
- Recent Activity — Latest status report summary

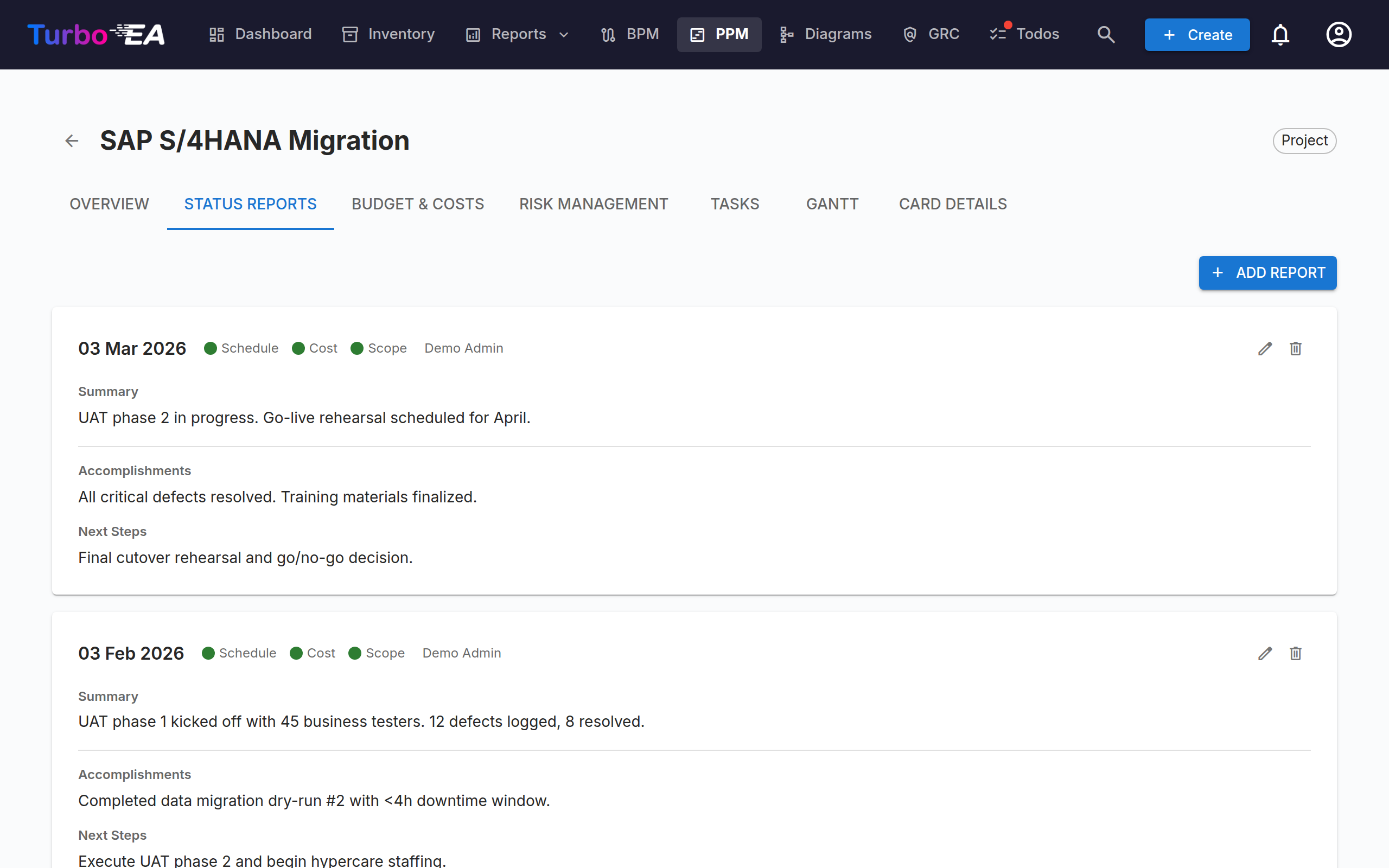

Status Reports Tab¶

Monthly status reports track project health over time. Each report includes:
| Field | Description |
|---|---|
| Report Date | The reporting period date |
| Schedule Health | On Track, At Risk, or Off Track |
| Cost Health | On Track, At Risk, or Off Track |
| Scope Health | On Track, At Risk, or Off Track |
| Summary | Executive summary of current status |
| Accomplishments | What was achieved this period |
| Next Steps | Planned activities for the next period |

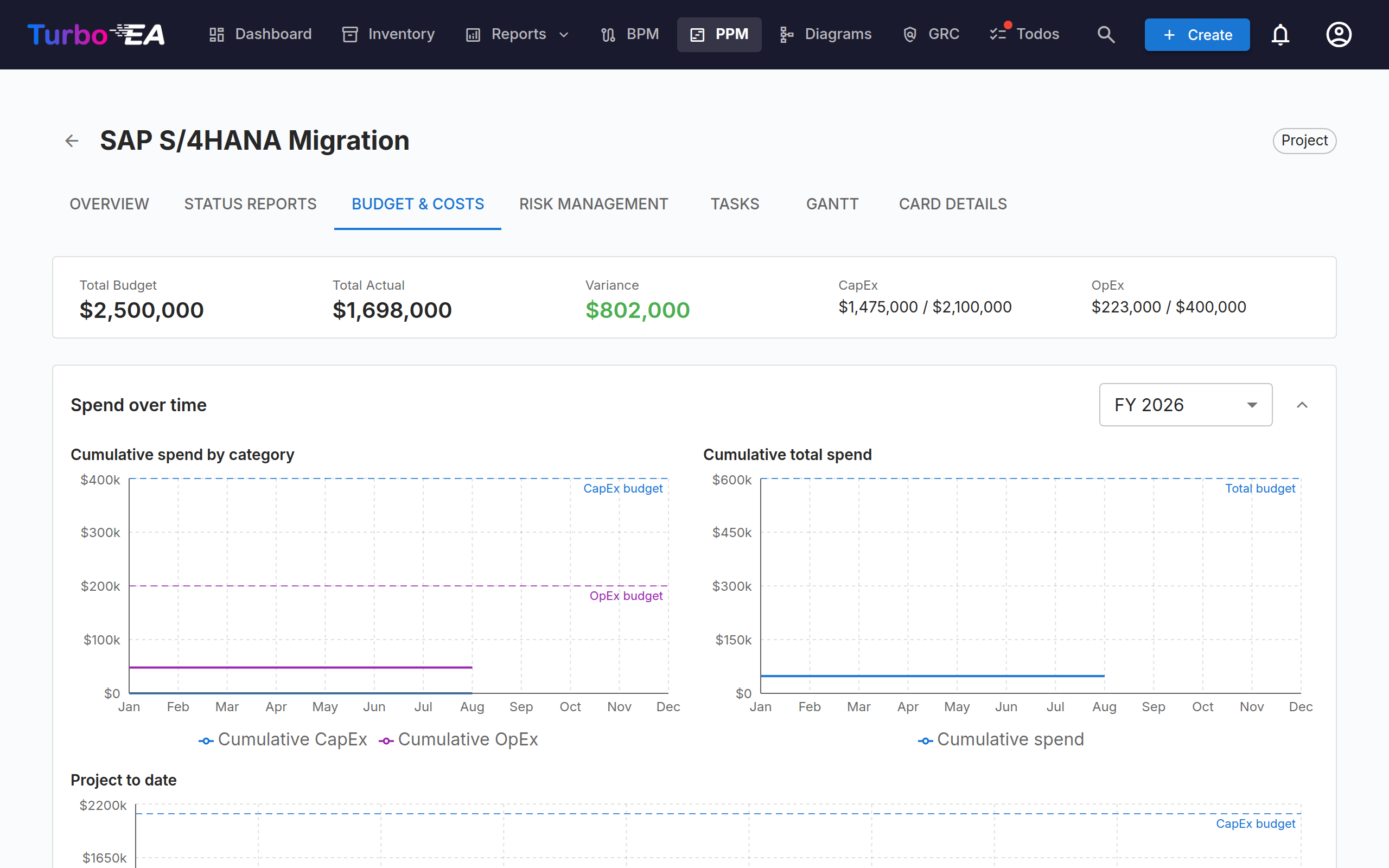

Budget & Costs Tab¶

Track financial data with two types of line items:
- Budget Lines — Planned budget by fiscal year and category (CapEx / OpEx). Budget lines are grouped according to the fiscal year start month configured in Settings. For example, if the fiscal year begins in April, a budget line dated June 2026 belongs to FY 2026–2027
- Cost Lines — Actual expenditures with date, description, and category
Budget and cost totals automatically roll up to the Initiative card's costBudget and costActual attributes. When PPM cost lines exist, these card fields are marked as auto-computed and become read-only in the card detail view.
Spend Over Time¶
Above the budget and cost tables, three charts plot how spend has accumulated month by month:
- Cumulative spend by category — cumulative CapEx and OpEx for the selected fiscal year, with dotted horizontal lines marking the CapEx and OpEx budget for that year
- Cumulative total spend — the same fiscal year with both categories combined, against a dotted total-budget line
- Project to date — cumulative CapEx and OpEx across every month of the project, against the total budget for all fiscal years
The fiscal-year selector applies to the first two charts and offers the current year, any other year with data, and All fiscal years. Your fiscal-year and expand/collapse choices are remembered between visits.
Two things to be aware of when reading the charts:
- Lines stop at the current month rather than running flat to the end of the year, so an unfinished year is not mistaken for one where spending has stopped
- Cost lines with no date cannot be placed on a timeline and are left out. A note below the charts reports how many were excluded, so the chart totals can be reconciled with the summary bar

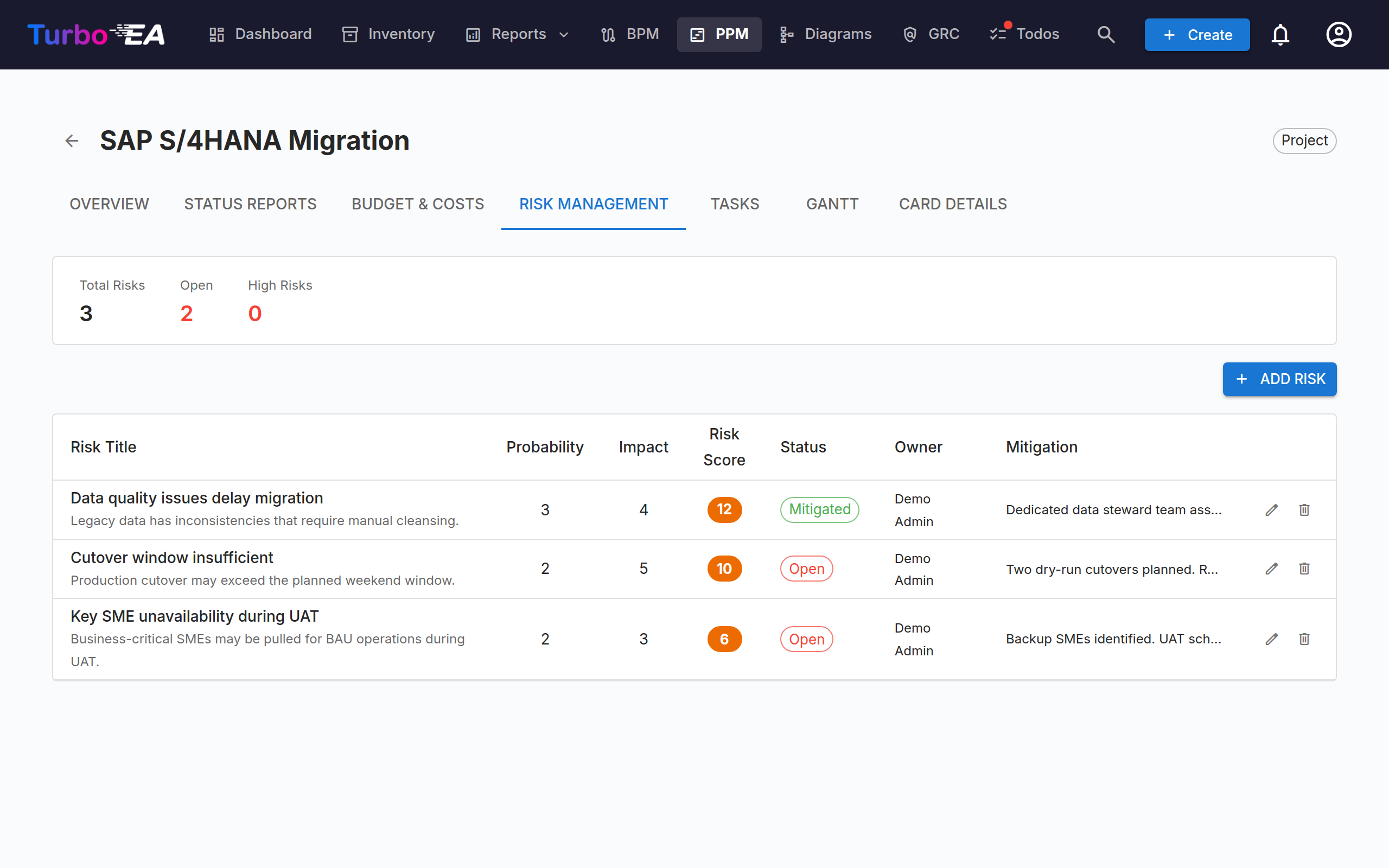

Risk Management Tab¶

The risk register tracks project risks with:
| Field | Description |
|---|---|
| Title | Brief description of the risk |
| Probability | Likelihood score (1–5) |
| Impact | Impact score (1–5) |
| Risk Score | Auto-calculated as probability x impact |
| Status | Open, Mitigating, Mitigated, Closed, or Accepted |
| Mitigation | Planned mitigation actions |
| Owner | User responsible for managing the risk |

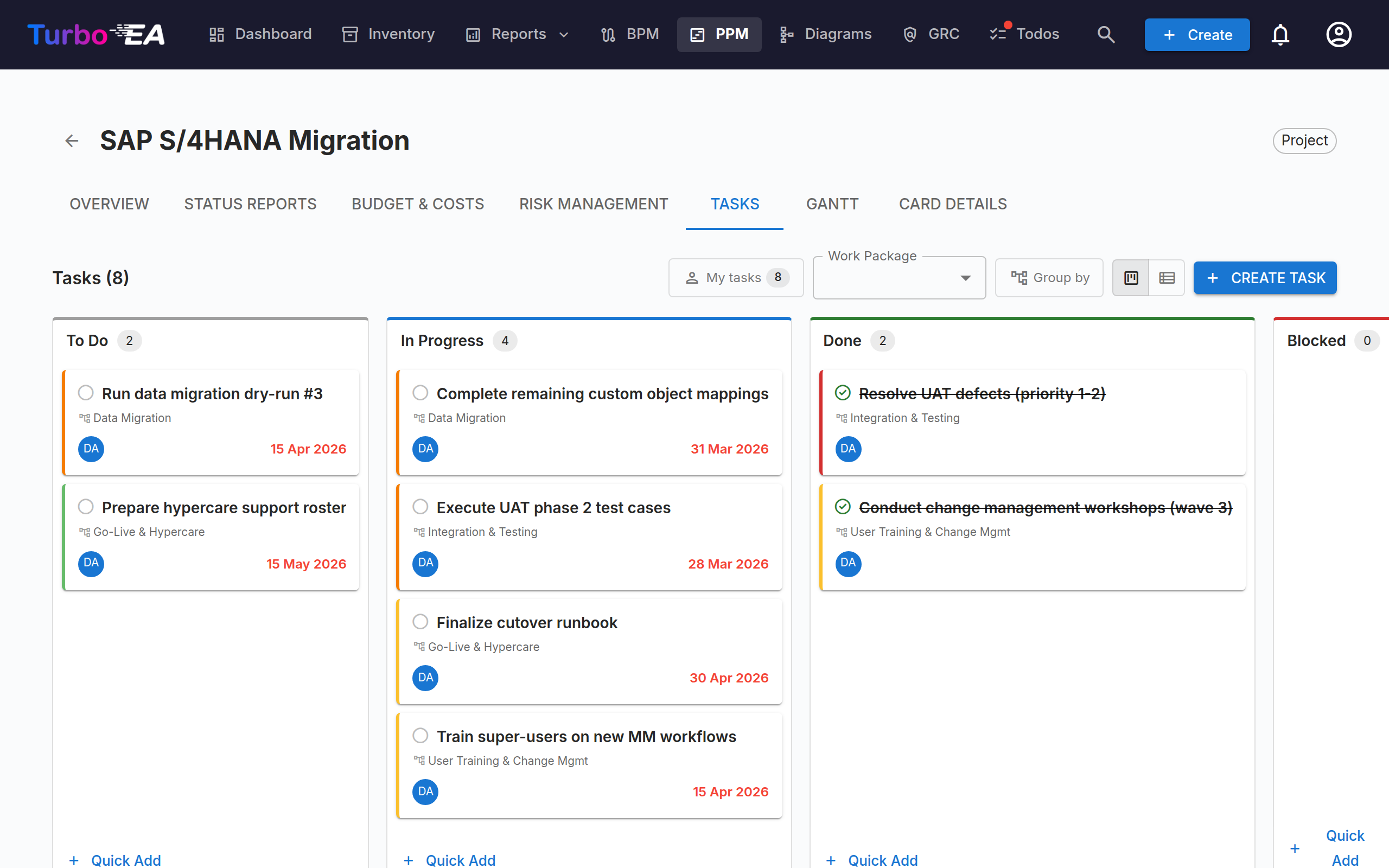

Tasks Tab¶

The task manager supports both Kanban board and list views with four status columns:
- To Do — Tasks not yet started
- In Progress — Tasks currently being worked on
- Done — Completed tasks
- Blocked — Tasks that cannot proceed
Tasks can be filtered and grouped by Work Breakdown Structure (WBS) item. When grouped, every work package appears as a group — including one that holds no tasks yet, which shows a hint and an Add Task button that opens the task dialog with that package preselected. Milestones appear only once they hold a task. Drag and drop cards between columns to update status. Each task supports:
- Priority levels (Critical, High, Medium, Low)
- Assignee (with notification on assignment)
- Start and due dates
- Tags for categorization
- Comments for discussion
Display filters (view mode, WBS filter, group-by toggle) persist in the URL across page refreshes.

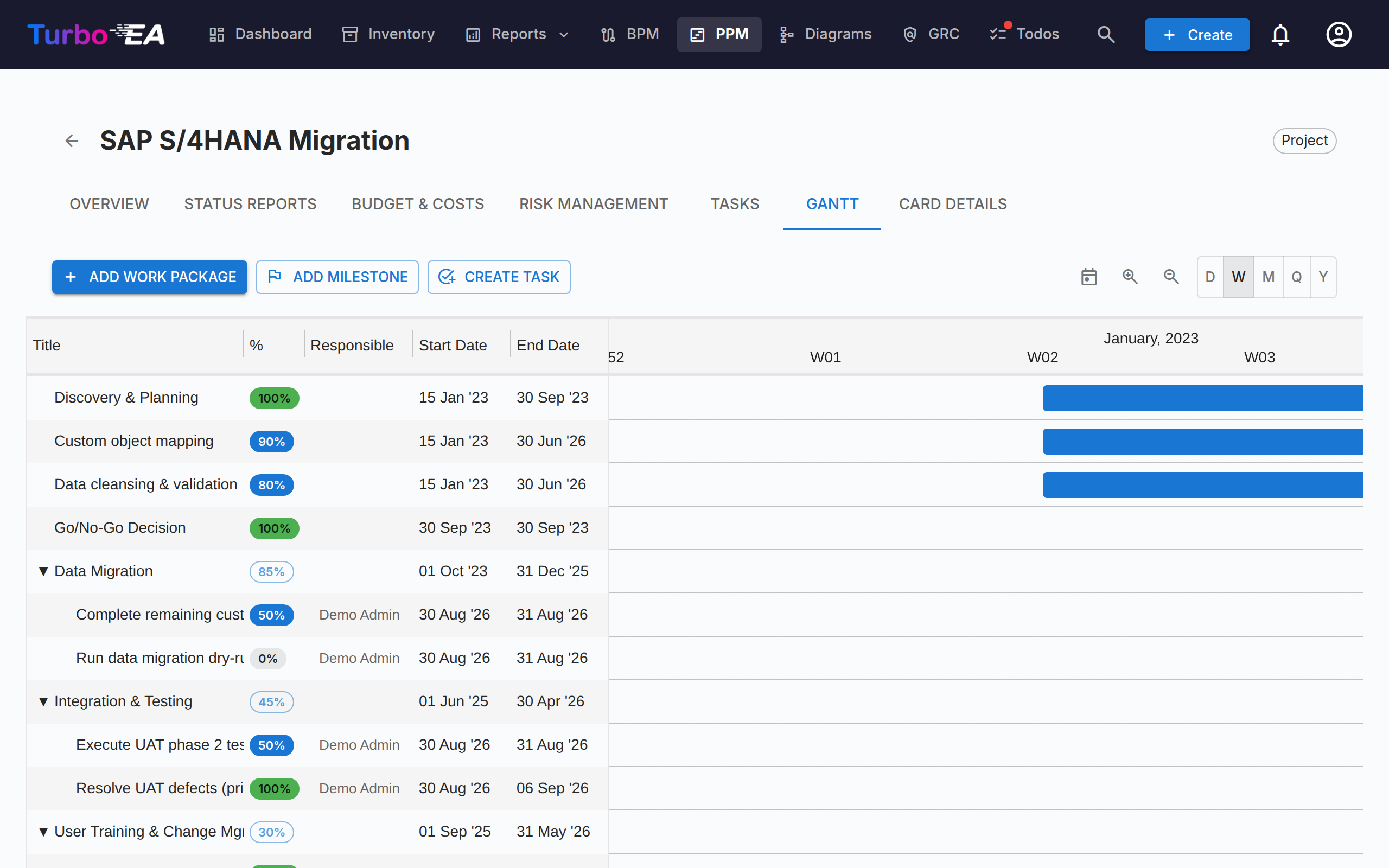

Gantt Tab¶

The Gantt chart visualizes the project timeline with:
- Work Packages (WBS) — Hierarchical work breakdown structure items with start/end dates
- Tasks — Individual task bars linked to work packages
- Milestones — Key dates marked with diamond indicators
- Progress Bars — Visual completion percentage. A task has no percentage of its own: its fill follows its status — To Do (0%), In Progress (50%), Done (100%). Click the percentage chip on a task to open a slider whose three stops are labelled with those statuses; choosing a stop changes the status, and dragging the fill on the task's bar does the same. A leaf work package has a free slider in 5% steps. Work packages that have child work packages or tasks show a read-only chip whose value is rolled up automatically from the subtree.
- Quarterly Ticks — Timeline grid for orientation
Interact with the Gantt chart using:
- Drag bars to reschedule items
- Resize bar edges to change duration (1-day granularity)
- Right-click for context menu (edit, add task, mark done, delete)
- Today button to scroll to the current date
- View scale picker — choose between Day, Week, Month, Quarter, and Year scales; the choice is remembered in your browser
- Zoom in / Zoom out buttons — step through the same five scales one notch at a time
- Drag the dot on the right edge of one bar onto the dot on the left edge of another to create a finish-to-start dependency arrow. Dependencies work between any combination of work packages and tasks. Cycles are rejected automatically. Double-click an arrow to remove it.
- The + row at the bottom of the list asks what to create — a work package, a milestone or a task — so a task typed there lands on the Tasks tab.
Card Details Tab¶
The last tab shows the full card detail view, including all standard sections (description, lifecycle, attributes, relations, stakeholders, comments, history).
Work Breakdown Structure (WBS)¶
The WBS provides a hierarchical decomposition of project scope:
- Work Packages — Logical groupings of tasks with start/end dates and completion tracking
- Milestones — Significant events or completion points
- Hierarchy — Parent-child relationships between WBS items
- Auto-completion — Completion is calculated automatically from the tasks in a work package's subtree: each task counts as 0% (To Do, Blocked), 50% (In Progress) or 100% (Done), weighted by its duration in days (one day when a date is missing), then rolled up recursively to parent items. A work package with no tasks anywhere below it keeps the value typed by hand. The average of the top-level work packages is the initiative's overall progress — the number on the Overview tab, and the
ppm.completionvariable a calculated field can show on the card and in a portal
Card Detail Integration¶
When PPM is enabled, Initiative cards display a PPM tab as the last tab in the card detail view. Clicking this tab navigates directly to the PPM Initiative Detail View (Overview tab). This provides a quick entry point from any Initiative card to its full PPM project page.
Conversely, the Card Details tab within the PPM Initiative Detail View shows the standard card detail sections without the PPM tab, avoiding circular navigation.
Permissions¶
| Permission | Description |
|---|---|
ppm.view |
View the PPM dashboard, Gantt chart, and initiative reports, and read Initiative cards. Granted to all roles by default |
ppm.manage |
Create and manage status reports, tasks, costs, risks, and WBS items. Granted to Admin, BPM Admin, and Member roles |
reports.ppm_dashboard |
View the PPM portfolio dashboard. Granted to all roles by default |
